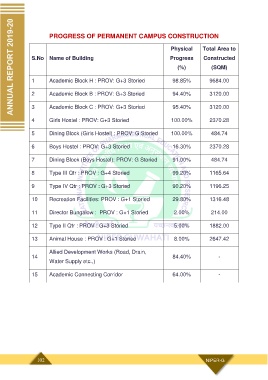

PROGRESS OF PERMANENT CAMPUS CONSTRUCTION
Physical Total Area to
S.No Name of Building Progress Constructed
(%) (SQM)
1 Academic Block H : PROV: G+3 Storied 98.85% 9684.00
2 Academic Block B : PROV: G+3 Storied 94.40% 3120.00
3 Academic Block C : PROV: G+3 Storied 95.40% 3120.00
4 Girls Hostel : PROV: G+3 Storied 100.00% 2370.28
5 Dining Block (Girls Hostel) : PROV: G Storied 100.00% 484.74
6 Boys Hostel : PROV: G+3 Storied 16.30% 2370.28
7 Dining Block (Boys Hostel): PROV: G Storied 91.00% 484.74
8 Type III Qtr : PROV : G+4 Storied 99.20% 1165.64
9 Type IV Qtr : PROV : G+3 Storied 90.20% 1196.25
10 Recreation Facilities: PROV : G+1 Storied 29.80% 1316.48
11 Director Bungalow : PROV : G+1 Storied 2.00% 214.00
12 Type II Qtr : PROV : G+3 Storied 5.00% 1882.00
13 Animal House : PROV : G+1 Storied 8.00% 2647.42
Allied Development Works (Road, Drain,
14 84.40% -
Water Supply etc.,)
15 Academic Connecting Corridor 64.00% -
